sphere-based design prototype — City of Los Angeles — 2026

the blight sphere diagnostic

A blighted parcel is not a failed building — it is a failed sphere. This prototype diagnoses which of six concentric systems collapsed first, then defines the smallest intervention that repairs that sphere and rebalances the others. The primary KPI is a sphere-rebalancing score, not unit count or FAR.

Grounded in: the LA Blight Remediation Pipeline ↗

6concentric sphere layers — site to market
8.42blight score at prototype parcel — Tier 1 eminent domain candidacy
3 / 6sphere layers in failure state at 267 S Ave 18
8.1sphere-rebalancing score for the proposed 2-unit + ADU program brief

diagnostic media packet

Beyond the building: the blight sphere diagnostic framework.

The presentation package turns the diagnostic into a shareable framework: six concentric failure layers, a four-step disposition cascade, and the sphere-rebalancing score used to judge whether an intervention actually repairs the failed systems around a parcel.

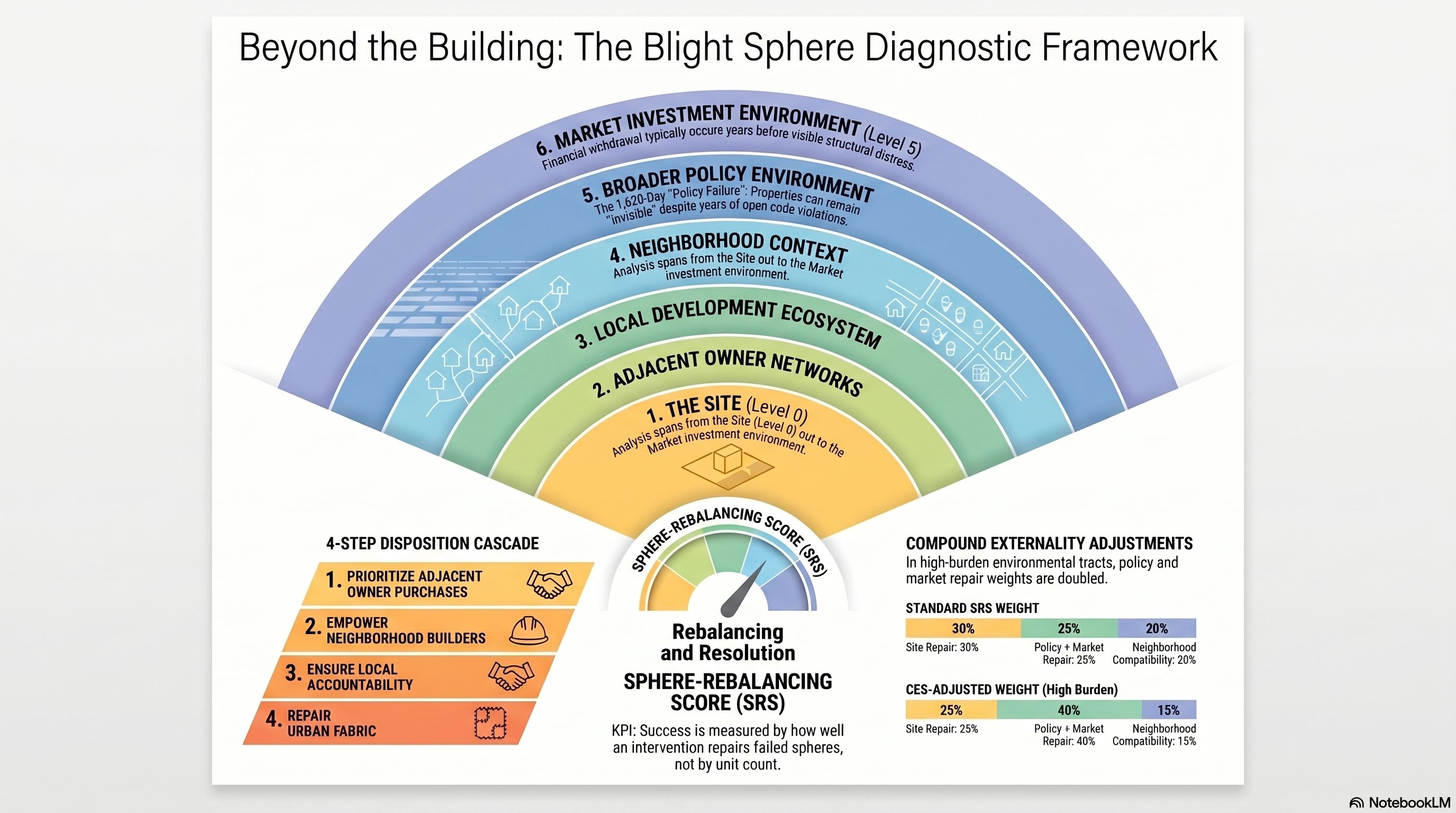

Blight Sphere Diagnostic Framework infographic showing six urban repair spheres, disposition cascade, and sphere-rebalancing score
framework poster - six spheres, disposition cascade, and compound externality adjustments

sphere failure map

Three of six spheres are in failure state at the prototype parcel.

5
Market sphere failed

investment environment

Zero permit activity since ≥2018. Land appreciation extracted without maintenance obligation. Owner received value uplift; civic goods were never delivered.

4
Policy sphere failed

regulatory environment

Fine-to-comply cycle ran to closure without physical remediation. 8 cases, 1,620 days open. Property structurally invisible to the active enforcement stream.

3
Infrastructure sphere stressed

service grid and mobility

Metro Bus 78/79 on N Broadway (0.25 mi). No rail within TOC-qualifying radius. Outside Tier 1–2 density bonus territory — base R2/R3 only.

2
Neighborhood sphere intact

named neighborhood context

No HPOZ on this parcel. HCM-587 (Lincoln Heights Jail) 0.4 mi north — area context, not a design constraint. Setback rhythm: consistent single-family residential.

1
Block sphere stressed

immediate block fabric

Intact bungalow stock on both sides bearing visual blight, suppressed land value, and structural safety risk as direct externality.

0
Site sphere failed

the parcel itself

Blight score 8.42 — extreme distress across all five visual dimensions. End-of-useful-life structure on a ~5,500 SF lot.

sphere failure sequence

Market sphere failed first — years before visible distress was registered.

Each failure loaded the next. Owner withdrawal (2015) meant no investment to arrest deterioration. Policy engagement (2019) reached the fine-to-comply limit without physical effect. Site sphere failure then accumulated without constraint until it registered as extreme visual distress in 2025.

~2015 Last permit activity

Final recorded investment at the parcel. Market sphere signal: owner withdrawal begins years before any visible distress.

~2019 First CSR violations opened

LADBS enforcement engages. Policy sphere activated — remediation still theoretically possible at this stage.

~2021–22 Fine-to-comply cycle runs

Violations opened, fines issued, cases closed — without physical remediation. Physical conditions unchanged. Cycle repeats.

~2024 Policy sphere failure

8 cases, 1,620 days open. Property invisible to the active enforcement stream. Site sphere failure accumulates unimpeded.

2025 Vision score 8.6 / 10

Street View confirms extreme distress: vegetation 9 · debris 9 · abandonment 9 · structural 8 · roof 8. Tier 1 candidacy.

six sphere layers — diagnosis inputs

Each sphere has distinct data sources and a distinct failure mode.

0
Site sphere the parcel itself
failed
  • Lot dimensions, legal configuration, zoning
  • Structure condition — visual + CSR record
  • Utility stub-outs, connection costs, easements
  • Ground-lease or community land trust status

Blight score 8.42 — extreme distress across all five visual dimensions. End-of-useful-life structure on a ~5,500 SF lot.

1
Block sphere immediate block fabric
stressed
  • Adjacent building conditions and use mix
  • Alley access, service routes, shared-wall adjacencies
  • Daylight and shadow envelopes
  • Debris spillover and buffer conditions

Intact bungalow stock on both sides bearing visual blight, suppressed land value, and structural safety risk as direct externality.

2
Neighborhood sphere named neighborhood context
intact
  • HPOZ boundaries and HCM adjacency
  • Street setback rhythm and massing character
  • Commercial corridor logic
  • Pedestrian network continuity

No HPOZ on this parcel. HCM-587 (Lincoln Heights Jail) 0.4 mi north — area context, not a design constraint. Setback rhythm: consistent single-family residential.

3
Infrastructure sphere service grid and mobility
stressed
  • Metro proximity and TOC tier entitlement
  • Bus frequency and stop-level amenity
  • Water, sewer, and electrical grid capacity
  • Bicycle facility and pedestrian infrastructure

Metro Bus 78/79 on N Broadway (0.25 mi). No rail within TOC-qualifying radius. Outside Tier 1–2 density bonus territory — base R2/R3 only.

4
Policy sphere regulatory environment
failed
  • SCEP violation history and CSR timeline
  • ED1, TOC eligibility, CEQA exposure
  • §17980 substandard building status
  • Deed restrictions, rent stabilization covenants

Fine-to-comply cycle ran to closure without physical remediation. 8 cases, 1,620 days open. Property structurally invisible to the active enforcement stream.

5
Market sphere investment environment
failed
  • Permit investment activity (5-year trend)
  • Ownership churn rate and purchase price history
  • Adjacent comparable sales and rent levels
  • Land value vs. replacement construction cost

Zero permit activity since ≥2018. Land appreciation extracted without maintenance obligation. Owner received value uplift; civic goods were never delivered.

sphere-rebalancing score

The KPI is not unit count or FAR — it is the degree to which the intervention repairs the failed spheres.

Score dimensions and weights

Site sphere repair 30%
Block sphere repair 25%
Neighborhood compat. 20%
Policy + market repair 25%
Site sphere repair

Resolves physical distress, abandonment, structural safety risk

Block sphere repair

Reduces externality on adjacent parcels — daylight, value, visual blight

Neighborhood compat.

Matches street character, setback rhythm, residential scale

Policy + market repair

Structurally prevents recurrence — ownership covenant, occupancy obligation

Worked example — 267 S Ave 18, proposed 2-unit + ADU program

Adjacent owner priority purchase · owner-occupant acquisition · alley ADU · residential setback-match at grade.

Site sphere repair 30%
9/10 → 2.70

Full demolition and code-compliant rebuild resolves all five distress conditions.

Block sphere repair 25%
8/10 → 2.00

Setback-matching infill, alley ADU; daylight preserved, visual blight eliminated.

Neighborhood compat. 20%
8/10 → 1.60

Residential program matches S Avenue 18 single-family setback rhythm.

Policy + market repair 25%
7/10 → 1.75

Proximity freedom cascade applied; no mandatory covenant if adjacent owner purchases at market rate.

Composite SRS 8.1 / 10 strong rebalancing — all four sphere dimensions measurably improved

disposition cascade — Tier 1 parcels

From eminent domain candidacy to community-priority sale in four steps.

The sphere-rebalancing score determines the design program. The disposition cascade determines who builds it and under what covenant. Both together close the loop between physical repair and market / policy sphere repair.

1
Owner final notice 90 days

Final compliance notice with concurrent FMV buyout offer. Owner may self-remedy or exit at market rate. Non-response triggers Step 2.

2
Adjacent owner priority purchase 45 days proximity freedom

Adjacent parcel owners offered exclusive window to purchase at FMV. Basis: they are the primary externality victims and hold the strongest claim on remediated land.

3
Neighborhood builder RFP 60 days local accountability

Qualified residential builders within the council district offered the site. Residential or mixed-use construction within 18 months required. 10-year affordability covenant on ≥1 unit.

4
Open competitive bid rolling

Public bid to any qualified developer. Residential or mixed-use required. No land-banking permitted.

compound externality adjustment

In CES ≥90th-percentile tracts, policy + market repair weight doubles.

Where a blighted parcel sits in a CalEnviroScreen extreme-burden tract, the infrastructure and neighborhood spheres are already under load before the site failure adds its own cost. A design response that resolves only the site sphere leaves the compound failure intact. The SRS adjusts: policy + market repair weight rises from 25% to 40%.

Standard weights

CES < 90th percentile

Site 30%
Block 25%
Neighborhood 20%
Policy 25%

CES-adjusted weights

CES ≥ 90th percentile

Site 25%
Block 20%
Neighborhood 15%
Policy 40%

The blight pipeline's invisible-blight findings — zero active CSR records, extreme visual distress, 99th-percentile CES tracts in South LA and East LA — are precisely this class of compound failure: both the policy sphere and the infrastructure sphere have failed simultaneously, and neither failure appears in the city's enforcement data. The CES-adjusted SRS is the appropriate scoring framework for those parcels.
